When a Critical Dependency or Remote Team Falls Behind

Cross-functional Collaboration — a critical component you don’t own is slipping and threatens your launch, or a remote or vendor team has fallen behind and the process and timeline need resetting; how you diagnose the real cause, manage the stakeholders, and get the project back on track.

Student edition · understand, apply, verify

Respond to a dependency delay with joint evidence, support, realistic replanning, and explicit fallback constraints.

What you should be able to do: Separate a date estimate from a commitment and verify whether degraded/fallback behavior is actually acceptable.

Context-dependent collaboration guidance. Examples/numbers are illustrative; first-person practice drafts are not verified personal history. Respect decision rights, safety/legal obligations, privacy, and the partners' actual capacity. No framework guarantees agreement or delivery.

Concepts explained in this guide

Read these definitions first, or use the linked terms as you go. The examples and limitations are local to this guide; companion pages are optional.

Stakeholders and alignment

A stakeholder is affected by or able to affect a decision. Alignment means understanding goals, constraints, tradeoffs, and the decision process; it does not require unanimous agreement.

Example. Finance values cost predictability, customers migration effort, and operations safe recovery. State these criteria before choosing.

Boundary. Consultation is not an unlimited veto. Name decision authority, required evidence, deadline, and escalation.

Ownership, accountability, and decision rights

Ownership names who drives follow-through; accountability names who answers for outcomes. Decision rights specify who chooses/approves and who is consulted.

Example. A migration has a coordinating owner, service owners, and named release authority.

Boundary. DRI/RACI/DACI are local conventions, not guarantees. Role labels do not replace authority, capacity, and follow-through.

Decision records and reversible experiments

Record the problem, options, evidence, constraints, owner, chosen tradeoff, and reconsideration trigger. A reversible test reduces uncertainty before large commitment.

Example. Try one tenant with success/abort metrics and a data-safe rollback plan.

Boundary. Timeboxing does not bypass compliance/safety. Reversible means effects and data can actually recover, not merely that a flag exists.

Opportunity cost and prioritization

Opportunity cost is benefit forgone by choosing one investment over another. Compare expected value, effort, uncertainty, constraints, and dependencies under finite capacity.

Example. A feature can delay reliability work; compare user benefit with risk reduction and explain the choice.

Boundary. ROI/RICE/weighted scoring are aids, not exact laws. Units, uncertainty, mandatory constraints, and critical paths can dominate scores.

Outputs, outcomes, and measurement

Outputs are produced things; outcomes are changes for users/business/team. Useful metrics state definition, denominator, population, period, and attribution limits.

Example. 'Shipped a tool' is output. 'Median onboarding fell ten to six days in this cohort' is an outcome with sample/context caveats.

Boundary. Before/after does not prove sole causation. Avoid gaming, selection bias, hidden costs, and unlike-team comparisons.

This question separates leaders who manage a plan from leaders who manage reality. A weak answer either escalates instantly (throwing the other team under the bus), assumes the remote or vendor team simply is not working hard enough, or absorbs the slip in silence and hopes it recovers. A strong answer shows you lead with curiosity, not blame: you get to ground truth fast, distinguish a real slip from a schedule wobble, and diagnose whether the cause is engineering, scope, priority, or a broken working relationship — unclear specs, timezone latency, missing access, or a dependency you owe them. Then you work the problem with the owning team before escalating, adapt the process and re-baseline the timeline instead of just pushing the date, protect your launch with options rather than ultimatums, and escalate cleanly and early when the data says you must — all while protecting a partnership you will need again. Answer in CARL shape — Context, Actions, Results, Learnings — and spend most of your words on the Actions.

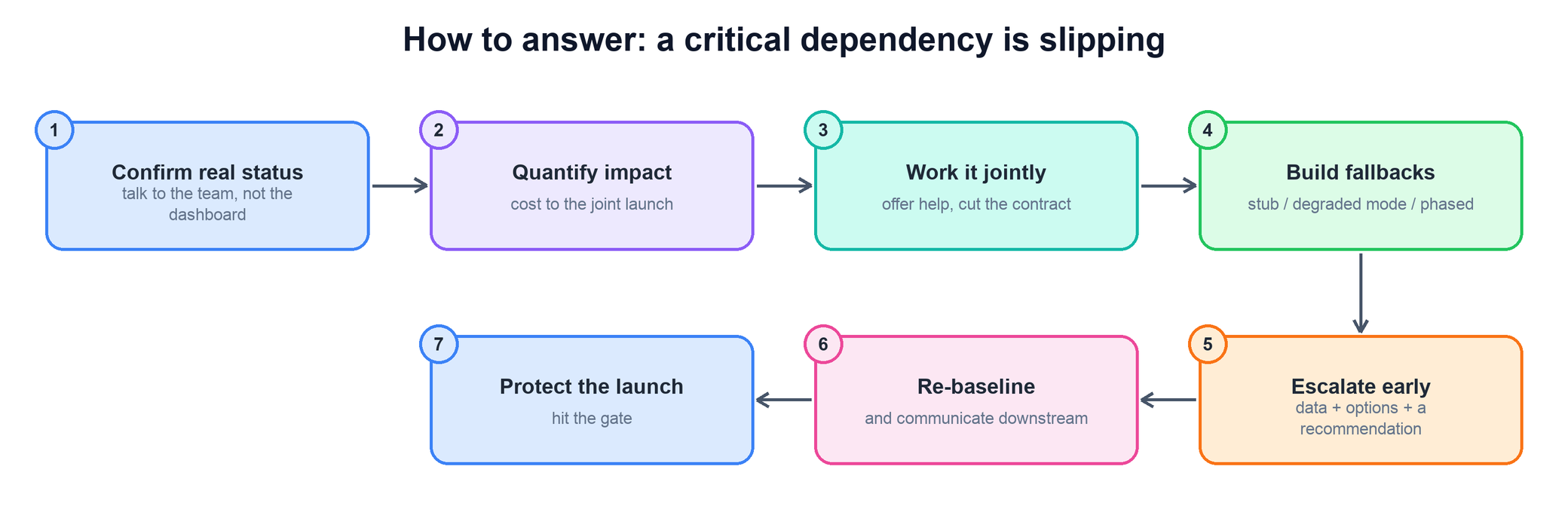

Answer flow for managing a slipping critical dependency
The spine: confirm the real status → quantify impact on your launch → work the problem jointly → build fallback options → escalate early with data → re-baseline and communicate → protect the launch.

What this question is really testing

Whether you can lead through influence rather than authority. The team that is slipping does not report to you, may be in another timezone, and may have its own competing priorities. The interviewer wants to see that you can build a shared picture of reality without blame, create pressure through transparency rather than politics, and make a hard call — wait, work around, cut scope, or move the date — with a clear head. It also tests whether you protect the relationship: you will need this team again, so how you handle the slip matters as much as whether you hit the date.

How to answer What the interviewer is looking for

A worked example (CARL)

Practice draft: first-person narratives below are not independently verified autobiographical evidence. Use their structure, not their claimed results; replace with your genuine safe-to-share experience.

Context. On the Ads Events / AIMS storage team we were launching a new low-latency read path for an events product, and it depended on a schema-and-throughput change owned by a remote ingestion team two timezones away. Their piece was on the critical path — without it our launch gate could not pass — and about five weeks out their status quietly moved from green to yellow, then their weekly update slipped a milestone with no explanation. Two downstream teams were sequencing their own work behind our launch, so a slip on our side would cascade.

Actions. I resisted the urge to fire off an escalation email and instead set up a direct working session with their tech lead and the two engineers actually doing the work — scheduled in the overlap window of our timezones so it was a real conversation, not an async ping. What I learned changed everything: it was not a one-off slip, it was a priority conflict. Their team had been pulled onto a separate reliability effort, and our change had lost an engineer to it. So the problem was not engineering, it was prioritization, and that told me the fix had to happen at the manager level — but not yet, and not as a fight. First I made the impact undeniable and shared: I wrote a one-page brief that translated their slip into concrete downstream cost — the gated launch, the two teams queued behind us, and the customer-facing commitment — and I framed it as “our joint launch is at risk,” not “you are late.” Then I looked for ways to buy the date back on our side of the fence: I offered to lend one of my engineers who knew the ingestion schema to pair with theirs, and I proposed cutting the interface contract down to the minimum our launch actually needed, deferring the richer version to a fast-follow. In parallel — and this is the part I care most about — I built a fallback so we were never hostage to their recovery: a degraded-mode read path that used the existing ingestion format, slower but launchable, that would let us hit the gate with reduced scope if their change did not land. We co-owned a written recovery plan with two checkpoints. When the first checkpoint slipped, I escalated exactly as I had told them I would — a joint note to both managers, with the impact brief, the recovery plan, the options, and a clear recommendation to either restore the engineer for two weeks or approve our reduced-scope launch. Because I had escalated with data and options rather than blame, the conversation was about priority, not about fault, and it resolved in one meeting.

Results. The two managers restored the engineer for a focused two-week push, and with my lent engineer pairing on the schema, the reduced-contract version landed in time to pass the launch gate. We shipped roughly on the original date with slightly trimmed scope and fast-followed the richer interface a few weeks later. The downstream teams stayed on their sequence. Just as importantly, the ingestion team came out of it as a stronger partner — because I had led with help and transparency, not politics, they trusted us on the next joint project.

Learnings. Two things. First, a status dashboard tells you that something slipped; only talking to the people doing the work tells you why, and the why determines whether the fix is engineering, scope, or prioritization. Second, always build the fallback in parallel — the reason I could escalate calmly and negotiate from strength was that I was never actually dependent on a single outcome. Optionality is what turns a crisis into a decision.

Common follow-ups

When exactly do you escalate versus keep working it yourself?

How to answer

How do you keep the relationship intact when you have to escalate over their head?

How to answer

What if there is no viable fallback and their piece is truly required?

How to answer

How do you spot a slip early instead of at the last checkpoint?

How to answer

What changes when it’s an external vendor vs. an internal partner team?

How to answer

How do you re-baseline a timeline without losing trust?

How to answer
Evidence to collect with your approved tools

Worked example: a dependency slips by three weeks

Use the following scenario to practice making goals, uncertainty, responsibility, and evidence explicit.

a dependency slips by three weeksEstablish current evidence: Ask the owners what remains, what assumptions changed, and whether your team owes access/specification/other inputs.. Compute downstream effects: Map critical-path milestones and capacity, not just an overall red status.. Compare supported options: Offer help, reduced scope, a safe adapter/fallback, or a changed launch date; a stub cannot fake a required correctness/security function.. Rebaseline and review: Name decision authority, owners, explicit checkpoint evidence, and early escalation triggers. Avoid forcing unsustainable timezone availability.1Establish current evidence2Compute downstream effects3Compare supported options4Rebaseline and review
Sequence for this example. The table explains the evidence and decision at each step.
StepEvidence, decision, and expected result
Establish current evidenceAsk the owners what remains, what assumptions changed, and whether your team owes access/specification/other inputs.
Compute downstream effectsMap critical-path milestones and capacity, not just an overall red status.
Compare supported optionsOffer help, reduced scope, a safe adapter/fallback, or a changed launch date; a stub cannot fake a required correctness/security function.
Rebaseline and reviewName decision authority, owners, explicit checkpoint evidence, and early escalation triggers. Avoid forcing unsustainable timezone availability.
Check your understanding: Should a fallback always be built to preserve the date?

Only if it satisfies permitted user, safety, security, and data semantics at acceptable cost. Otherwise replan or move the date.

Practice with your own situation

Choose a real cross-team decision. Record the shared problem, each party's constraints, options, assumptions, authority, agreed actions, owner/date, observed outcome, and reconsideration trigger. Use authorized evidence and distinguish contribution from attribution.

Use genuine, safe-to-share evidence. Example numbers here illustrate reasoning; they are not claims about your work or a guaranteed outcome.

Sources and further verification
⌂
